How to Quote a Stud Partition Wall: Timber, Plasterboard and Skim

Quick answer: To quote a stud partition wall: measure the wall area (height × width), calculate materials (timber studwork, noggins, plasterboard both sides, tape and jointing), price at current rates, calculate labour (typically 1–2 days for a two-person team depending on size and complexity), and add for any door openings, electrical first fix, or insulation within the cavity.
how to quote a stud wall hero
Knowing how to quote a stud wall means pricing every element — frame, board, insulation, jointing and skim — not just an hourly rate for the carpenter.

Knowing how to quote a stud wall properly is one of those skills that separates builders who make money from ones who wonder where their margin went. A stud partition looks simple — a frame, some board, a skim — but the costs stack up across timber, fixings, plasterboard, insulation, jointing compound, tape, beads and finishing labour. Miss any of them and you are working for free. This guide walks through every element of a stud wall quote, for both timber CLS and metal stud systems.

Measure First: What You Need to Know

Before you can price a stud partition, you need four things: the total wall length, the floor-to-ceiling height, the number and size of any door openings, and whether insulation is required.

stud spacing 400mm 600mm diagram
Standard stud spacing of 400mm or 600mm centres determines how many vertical studs you need — and drives the timber quantity take-off.

Key Measurements for the Take-Off

  • Wall length (m): measured along the floor line
  • Wall height (m): floor to underside of ceiling or soffit
  • Wall area (m²): length × height (both sides will need boarding)
  • Door opening count and size: standard single door 826 × 2040mm, wider doors or double doors priced separately
  • Acoustic or fire specification: drives board type and insulation specification

The wall area is the key number. You will use it to calculate plasterboard quantities (both faces), insulation quantities (one face), and to sense-check your labour time allowance.

Timber vs Metal Stud: Which to Price

The two dominant partition systems in domestic and commercial renovation are CLS timber stud and metal stud (sometimes called drywall or Metsec stud). Each has different material costs, labour rates and appropriate applications.

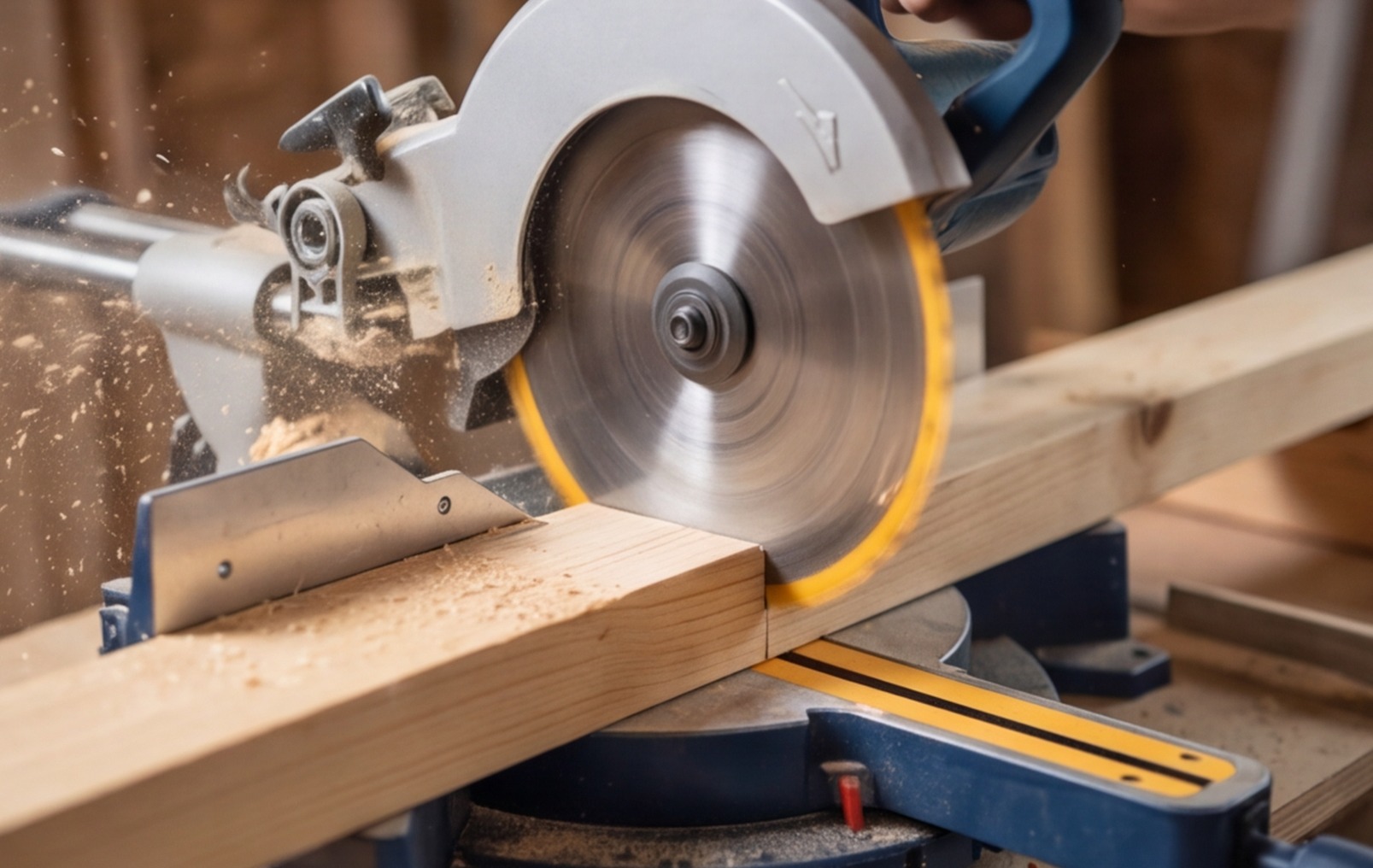

cls timber mitre saw cutting
CLS timber being cut to length on a mitre saw — the most common partition frame material on UK domestic refurbishments.
System Typical use Advantages Disadvantages
CLS timber stud (63mm or 89mm) Domestic partitions, load-bearing elements Easy to fix into, familiar to all trades, accepts standard fixings Subject to movement as timber dries; slightly more material cost
Metal stud (C-section 70mm or 100mm) Commercial and domestic, non-load-bearing only Does not shrink or warp; faster to build; better acoustic performance with correct detail Cannot carry heavy loads without specialist fixings; less familiar to some trades

On domestic refurbishments, CLS timber is the default unless the client or specification requires metal stud. On commercial conversions — HMOs, flats, offices — metal stud is often specified for acoustic and fire-rating reasons. If you are working on an HMO conversion, check our related guide on HMO conversion costs UK for the full partition scope typical on those projects.

Frame Materials and Quantities

Stud frame quantities are calculated from the wall dimensions. A standard timber stud partition at 400mm centres uses the following framing elements:

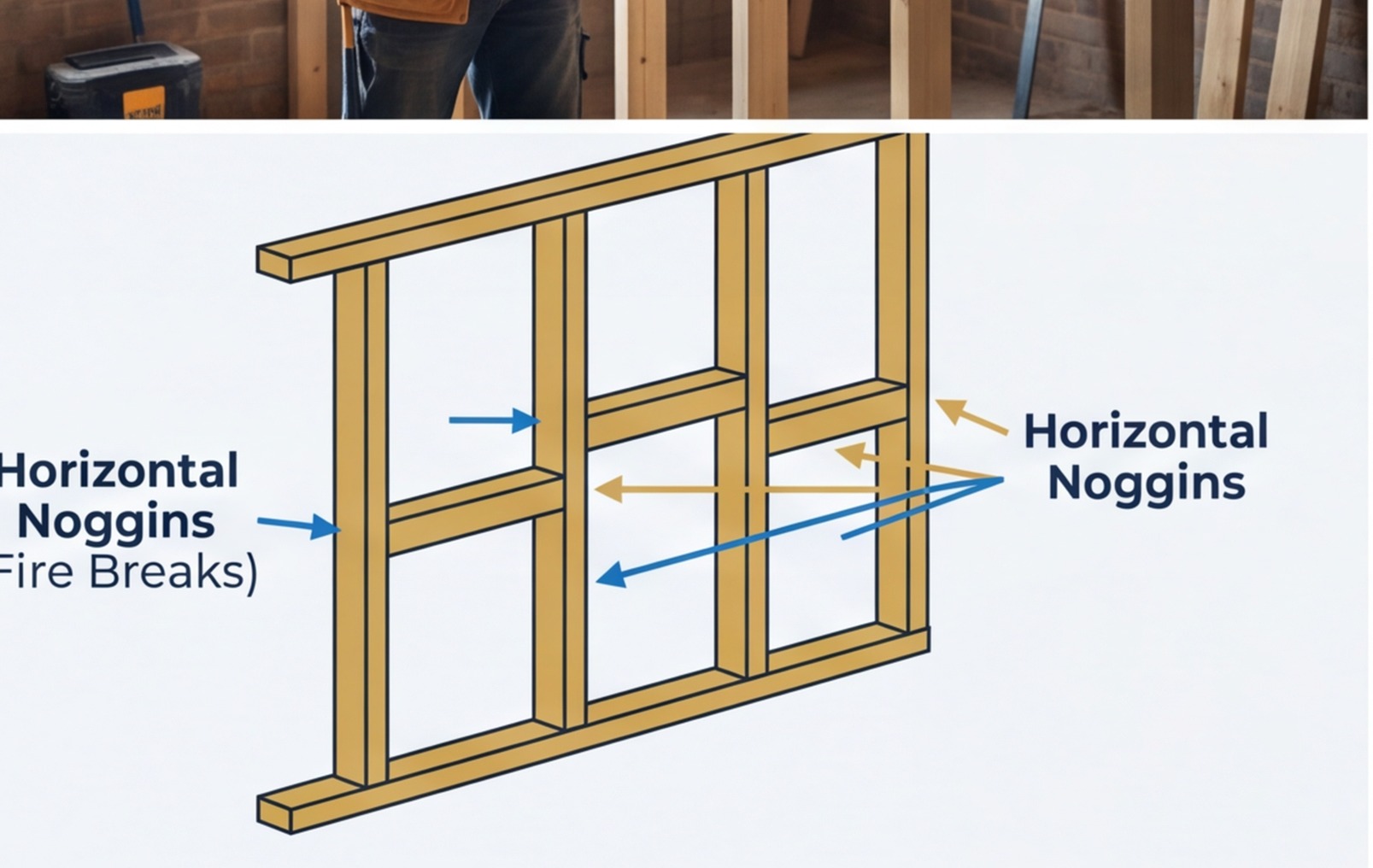

noggin placement stud wall diagram
Noggins placed at mid-height stiffen the partition and provide fixing points for sockets, switches and wall-hung items — always include them in your take-off.

Timber Take-Off for a Standard Partition

Element Quantity formula Standard section
Head plate (top) Wall length (m) + 10% waste 63 × 38mm CLS
Sole plate (bottom) Wall length (m) + 10% waste 63 × 38mm CLS
Vertical studs at 400mm centres (Wall length ÷ 0.4) + 1, × height + 15% waste 63 × 38mm CLS
Noggins at mid-height Stud count × noggin length (approx 400mm each) + 10% 63 × 38mm CLS
Screws / nails Allow 1kg of 75mm screws per 10 linear metres of wall 75mm C4 screws

For a 5m long, 2.4m high partition at 400mm centres with no door opening, a quick frame take-off looks like this:

  • Head and sole plate: 2 × 5m = 10m CLS (plus 10% waste = 11m)
  • Vertical studs: (5 ÷ 0.4) + 1 = 14 studs × 2.4m = 33.6m CLS (plus 15% = 38.7m)
  • Noggins: 13 × 0.4m = 5.2m CLS (plus 10% = 5.7m)
  • Total CLS timber: approximately 55–60 linear metres

At current trade prices for 63 × 38mm CLS, budget around £0.80–£1.20 per linear metre. For the above example, that is approximately £45–£70 in timber for the frame alone.

Plasterboard and Insulation

Both faces of the partition need plasterboard. Standard domestic partition spec is 12.5mm square-edge plasterboard for taped-and-jointed finishes, or tapered-edge board where a skim coat is applied.

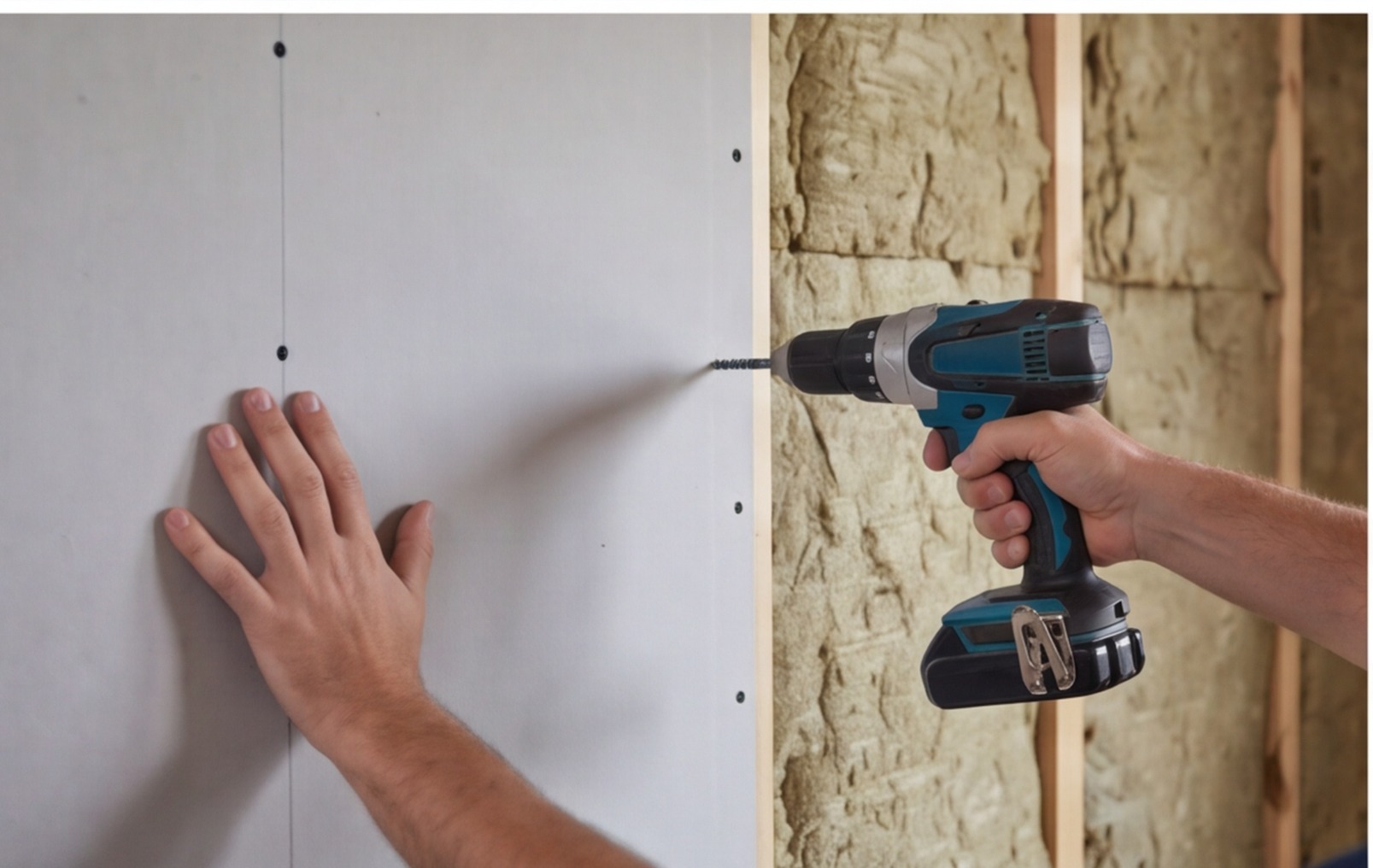

plasterboard screwed to stud frame
Plasterboard screwed to a CLS timber stud frame — screws at 300mm centres to studs and 150mm centres to noggins and perimeter fixings.

Plasterboard Quantities

  • Calculate the wall area: length × height = m²
  • Both sides of the partition: wall area × 2
  • Add 10–15% for waste and cuts
  • Convert to board count: standard board is 2400 × 1200mm = 2.88m²

For our 5m × 2.4m example: 5 × 2.4 × 2 = 24m² × 1.12 (waste) = 26.9m² ÷ 2.88 = 9.3, round up to 10 boards. At trade supply around £7–£10 per standard board, the plasterboard cost is approximately £70–£100.

Insulation

Insulation in a partition wall serves acoustic rather than thermal purposes. Standard practice for a partition between rooms where basic sound attenuation is wanted:

  • 50mm mineral wool slab or roll (Rockwool RWA45 or similar) — fills one face of the partition void
  • Quantity: wall area × 1 (one layer in the void) + 10% waste
  • Trade cost: approximately £3–£6 per m²

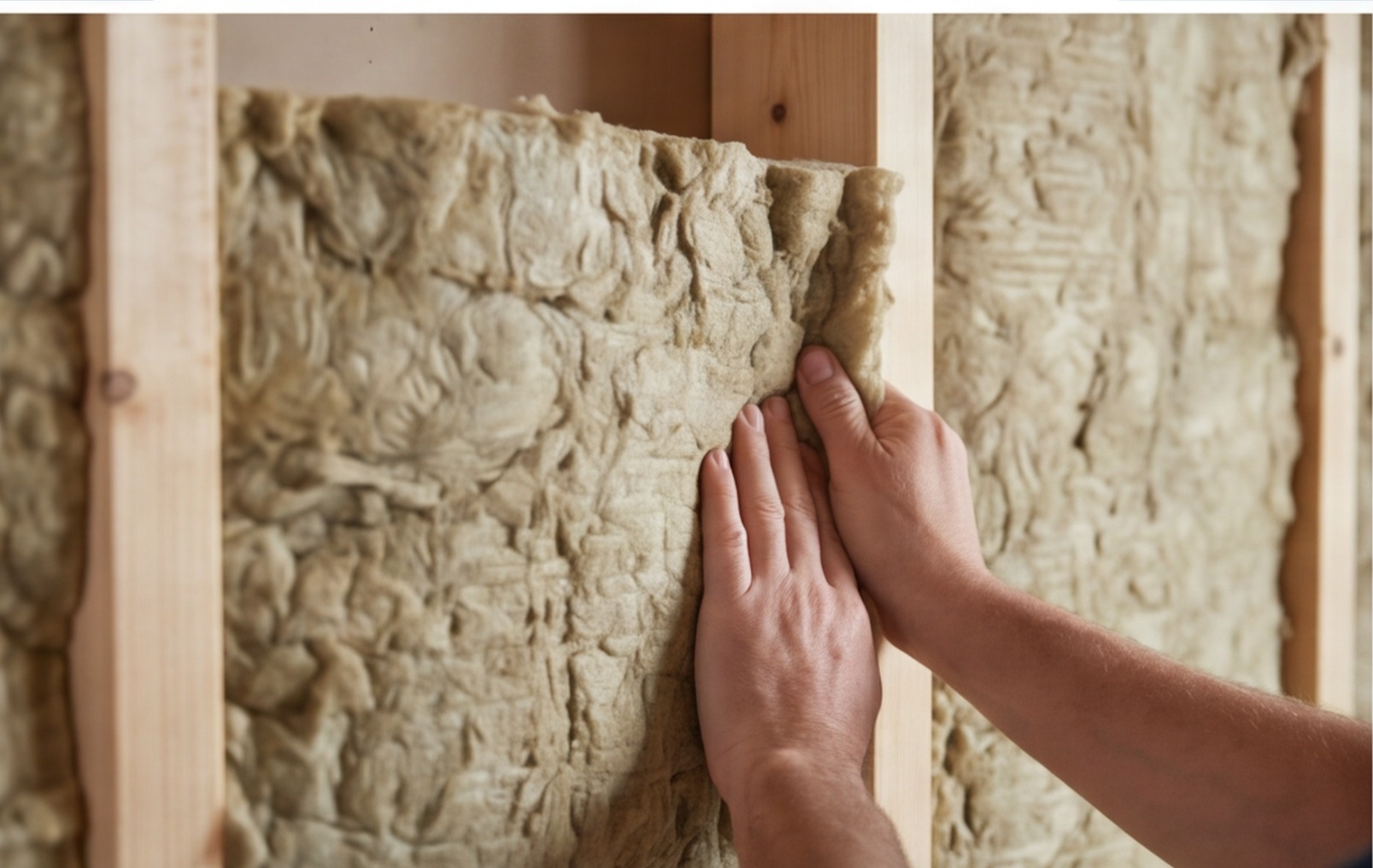

stud wall insulation installation
Mineral wool insulation fitted between studs before the second face of plasterboard goes on — essential for acoustic performance between rooms.

Where fire separation is required — between flats or between a house and attached garage, for example — specify fire-rated board (30-minute or 60-minute resistance as required) and acoustic insulation. Fire-rated board carries a significant price premium and must be specified correctly. Refer to Approved Document B (Fire Safety) for the relevant fire resistance performance requirements.

Door Openings and Lintels

Door openings in a stud partition require a header (lintel) above the opening and trimmer studs on each side. In a non-load-bearing timber stud partition at domestic ceiling heights, a double 38mm CLS header is typically sufficient — no structural steel required. In metal stud systems, purpose-made header sections are used.

Door Opening Frame Elements

Element Standard specification Notes
Trimmer studs (each side of opening) 2 × CLS per side = 4 pieces Full height + to underside of header
Header (lintel) 2 × CLS on flat, spanning opening + 100mm each side Double up if wide opening
Cripple studs above header As required to maintain stud pattern above opening —
Door frame / lining Client-supplied or specified separately State clearly in quote if excluded

Door linings, architraves and ironmongery are typically priced separately or flagged as client-supplied. Make this explicit in the quote — clients often assume the whole door is included when you have only priced the structural opening.

Jointing, Beading and Skimming

Once the boards are on, the finish options are taped-and-jointed (common in commercial or new build) or fully skimmed (common in domestic work where a painted finish must match surrounding plastered walls).

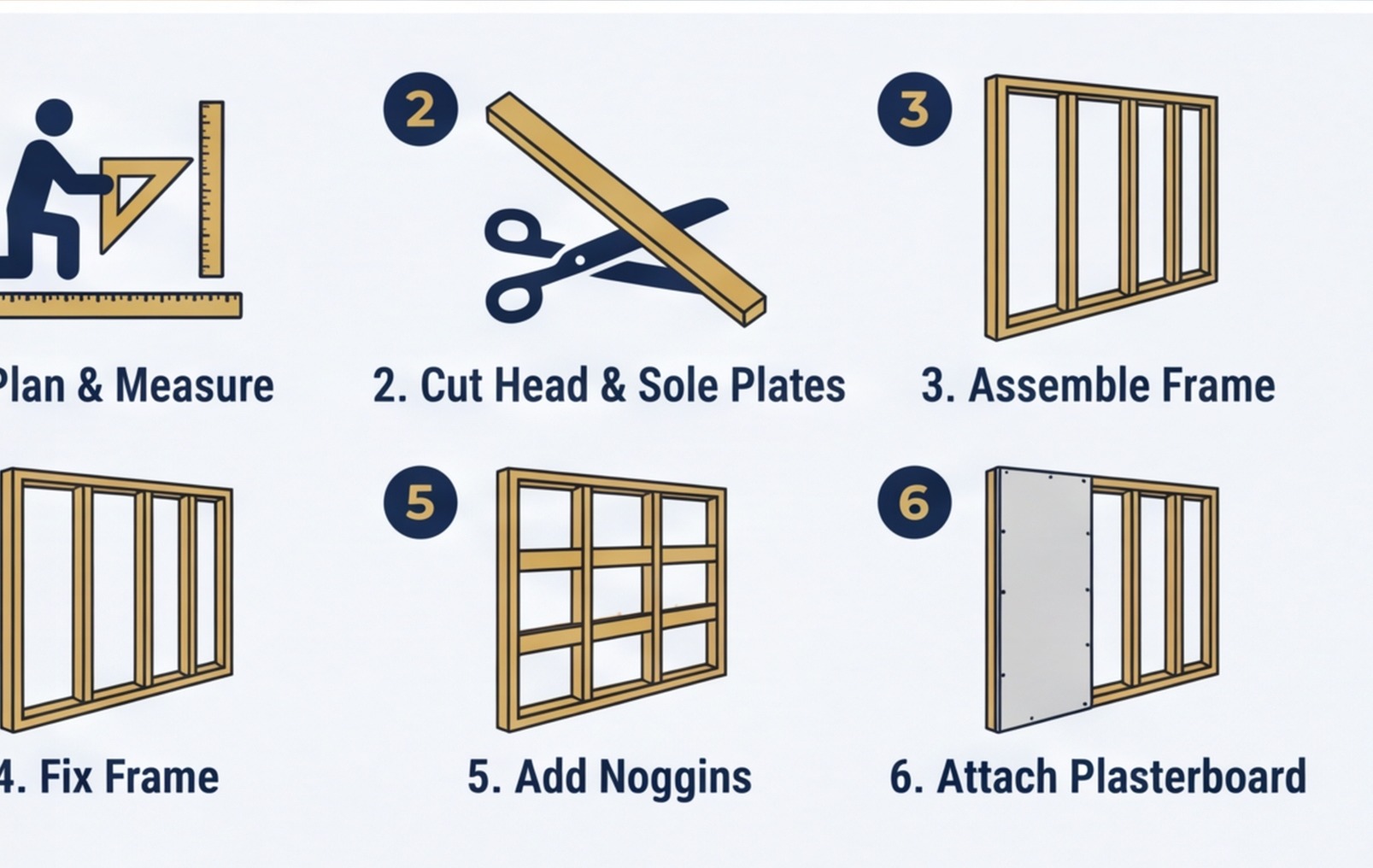

stud wall build 6 steps infographic
The six-step stud wall build process — from sole plate to skim coat — shows where each cost element sits in the build sequence.

Taped-and-Jointed vs Skimmed

Finish type Material cost per m² Labour Best for
Taped and jointed £1–£2.50 15–25 min per m² Commercial, new build, subsequent tiling
Skim coat (full) £1.50–£3.50 20–35 min per m² Domestic, painted finish matching plaster walls

Beads and Angles

External corners on a partition wall need metal angle bead — either galvanised steel or plastic corner bead — to protect the plaster edge from chipping. Budget around £1–£2 per linear metre of external corner. Measure the external corners from your survey to add this to your materials list.

Scrim tape is required at all board joints before skimming. Allow one roll of 90m scrim per 25–30m² of board area.

Labour, Waste and the Final Quote

With your materials take-off complete, you can build the labour estimate. Stud partition labour splits into three distinct phases:

stud wall materials checklist uk
A complete stud wall materials checklist — use this before pricing to ensure no item is missed from the quote.

Labour Allowances by Phase

Phase Typical rate per m² of wall
Frame erection (CLS timber) 0.3–0.5 hours per m²
Plasterboard fixing (both faces) 0.3–0.4 hours per m²
Insulation fitting 0.1–0.15 hours per m²
Skim coat (by plasterer) 0.3–0.5 hours per m²
Door opening framing Allow 2–3 hours additional per opening
Beading and scrim Allow 0.1 hours per linear metre of corner

For our 5m × 2.4m wall (12m²) with one door opening, a typical labour budget at £25–£35 per hour (carpenter) plus £30–£45 per hour (plasterer):

  • Frame: 12m² × 0.4h = 4.8h carpenter
  • Boarding both faces: 12m² × 2 × 0.35h = 8.4h carpenter
  • Insulation: 12m² × 0.12h = 1.4h
  • Door opening: 2.5h additional
  • Skim: 24m² × 0.4h = 9.6h plasterer

Total: approximately 17h carpenter + 9.6h plasterer. At mid-market rates, that is £425–£595 carpenter labour plus £288–£432 plasterer labour = £713–£1,027 labour, plus approximately £300–£450 in materials, giving a typical total range of £1,000–£1,500 for a simple 5m × 2.4m partition with one door.

sample stud wall quote uk
A sample stud wall quote showing itemised materials, labour and the total for a standard domestic partition with one door opening.

Waste Allowance

Always add a waste allowance on materials — 10% on timber, 12–15% on plasterboard (cuts are significant around door openings and where boards must be cut to height). This is not padding — it is genuine cost. Returning to a merchant for one board because you under-ordered is a real money and time loss.

To build stud partition quotes into a full project estimate, try RenoCalc — it calculates partition areas, board quantities and plastering take-offs automatically from your floor plan, so your stud wall cost is part of the full job quote rather than a separate calculation.

Looking to understand plastering rates for the skim finish? Read our guide on plastering cost per square metre UK. For the complete refurbishment cost picture, see our full house refurbishment cost UK guide.

You can also use our floor plan cost estimator to cross-check partition and room areas before your quote goes out. For health and safety on stud partition work including dust and manual handling, see the HSE dry lining guidance.
