How to Quote a Bathroom Renovation: Step-by-Step for Builders

how to quote a bathroom renovation hero
A bathroom renovation quote needs to cover every trade — not just the sanitaryware — or your margin will disappear fast.

Bathrooms are one of the most common renovation jobs — and one of the most under-quoted. I have seen good builders lose serious money on bathroom fits because they priced the sanitaryware and forgot to properly cost the plumbing, the tiling, the floor preparation and the electrical first fix. Knowing how to quote a bathroom renovation properly means surveying the room thoroughly, costing every trade in the right order, and presenting a quote that the client understands and you can actually deliver on.

This guide walks through the full process, from the initial survey to handing over the finished quote.

Survey First: Measure Everything Twice

Never quote a bathroom from a photo or a quick chat on the phone. You need eyes on the room. A 15-minute site survey is the difference between a quote that makes money and one that bleeds you dry from day one.

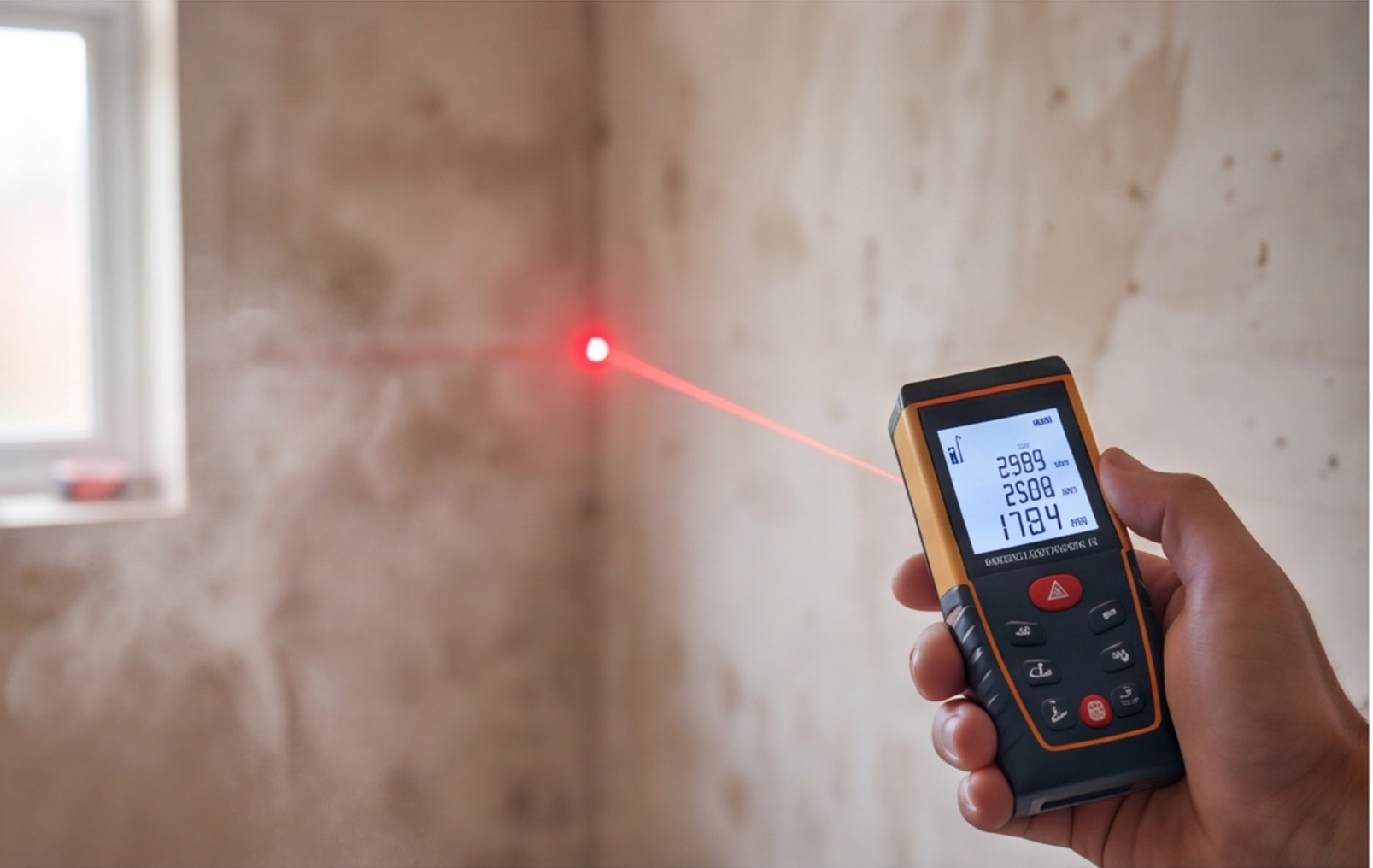

bathroom laser measuring tool
A laser measuring tool makes bathroom surveys faster and more accurate than a tape — especially on irregular walls.

What to Record on the Survey

On the survey, measure and note down:

  • Overall room dimensions — length, width, ceiling height
  • Position of existing soil pipe and waste runs
  • Position of existing hot and cold supply pipes
  • Location of existing consumer unit spur or FCU for towel rail / shaver socket
  • Condition of existing floor structure (bounce, rot, level)
  • Condition of existing walls (solid, stud, plasterboard, tiles on tiles)
  • Window position and size
  • Existing ventilation provision — fan, window, none
  • Access to the void below (for drainage runs)
  • Any known asbestos, damp or previous flood damage
bathroom floor plan dimensions uk
A simple floor plan sketch with dimensions gives you the take-off data needed for tiling, flooring and plumbing layout.

Sketch a rough floor plan on site — nothing fancy, just enough to show the layout, the drain positions and the wall lengths. This becomes the take-off sheet for your material quantities. If the client has already chosen sanitaryware, get the specification sheet. Different bath styles, shower trays and WC models have very different fixing and drainage requirements, and those differences affect your labour cost.

Costing the Strip-Out

Strip-out is where a lot of bathroom quotes fall short. It takes time — especially in older properties where tiles are bonded to sand-and-cement render, floor boards are nailed down in awkward corners, and the existing bath is cast iron.

bathroom quoting process 6 steps infographic
The six-step bathroom quoting process ensures every cost element is captured before the quote goes to the client.

Strip-Out Line Items to Cost

Item Typical time allowance Notes
Remove bath and waste 1–2 hours Add 1 hour for cast iron — disposal weight
Remove WC, soil connection and cistern 45 min Back-to-wall units take longer to disassemble
Remove basin and pedestal 30 min
Remove wall tiles (per m²) 30–45 min per m² Bonded cement render adds time significantly
Remove floor tiles 1–2 hours typical room Depends on adhesive bed type
Remove timber floorboards or chipboard 1–2 hours Allow for sub-floor inspection and repair
Skip hire / rubbish removal Allow minimum half skip for average bathroom

Always include waste removal as a named line item — never bury it in labour. It makes the quote transparent and gives you a real cost to recover.

Plumbing and Electrical First Fix

First fix is where the shape of the new bathroom is set. Get this costed correctly and the rest of the job flows. Cut it short and you will spend second fix chasing shoddy groundwork.

plumber tools bathroom floor
First fix plumbing in a bathroom means getting all waste runs, supply pipes and hot water feeds in place before boarding begins.

Plumbing First Fix Allowances

For a typical three-piece bathroom (bath, basin, WC) on a standard semi or terrace:

  • Reposition soil pipe or add new waste connection: 2–4 hours depending on run length
  • Hot and cold supply to bath: 2–3 hours copper or plastic
  • Hot and cold supply to basin: 1.5–2 hours
  • New waste runs to basin and bath: 1.5–2.5 hours
  • Shower valve rough-in (if replacing bath with shower): 2–3 hours
  • Towel rail plumbed feed: 1–2 hours if adding new feeds

Electrical First Fix Allowances

Bathroom electrics fall under Part P of the Building Regulations, so they must be carried out by a competent person or notified to building control. Cost the following:

  • Extractor fan spur and wiring: 2–3 hours
  • Shaver socket (Class II, outside Zone 2): 1.5–2 hours
  • Towel rail FCU (fused connection unit): 1–2 hours
  • Downlighters in bathroom zones — allow per light plus switching circuit
  • Part P notification or self-certification cost (if subbied out)

If you are using a subcontract electrician, get their written quote before your quote goes to the client. Never estimate a sparky's price — they will charge what they charge.

Tiling, Boarding and Plastering

Wall prep is where bathroom quotes fall short most often. Clients expect a flat, tiled finish. What they do not always appreciate is that getting a flat, tiled finish on walls that have had tiles ripped off them involves either cement boarding, dot-and-dab plasterboard, or skim to flat — all of which cost time and materials.

bathroom materials list infographic
A complete bathroom materials list prevents under-ordering and last-minute supply runs mid-job.

Wall and Floor Preparation

Preparation type When required Approximate cost per m²
Cement board to shower area Wet areas (shower enclosure, bath surround) £15–£25 per m² supply and fix
Plasterboard skim to remaining walls Where existing render is damaged after tile removal £12–£20 per m² supply and fix
Floor levelling compound Timber floors before tiling or vinyl £8–£15 per m² supply and apply
Waterproof membrane (tanking) Shower areas without cement board £10–£18 per m² supply and apply

Tiling Take-Off

Calculate your tiled areas from the floor plan sketch:

  • Full-height wall tiling area (m²) — wall length × height, less openings
  • Splash-back or half-height area (m²)
  • Floor tile area (m²) — room area less any areas not tiled
  • Add 10–15% wastage on patterned or diagonal tiles
  • Add grout, adhesive, trim pieces and spacers to materials list

If the client is supplying tiles, specify clearly in your quote that your tiling price is based on a standard 600×300mm format tile. Large-format tiles (900mm or over) require more adhesive bed preparation and more cuts — which means more time. Charge accordingly and note it as a variation trigger if the client changes format.

Sanitaryware, Second Fix and Flooring

Second fix is where the bathroom comes together — and where specification matters. The same bathroom space fitted with a budget suite takes half the time of one fitted with a freestanding bath, a wall-hung WC with concealed cistern, and a frameless shower enclosure with a linear drain. Price the product the client has actually chosen, not a generic allowance.

bathroom suite delivery uk
Confirm sanitaryware delivery timing with the client before quoting — late deliveries cause programme slippage and cost you money.

Second Fix Labour Allowances

Item Typical labour hours
Standard bath installation and connections 3–4 hours
Freestanding bath installation 4–6 hours (floor connections, aesthetics)
Standard close-coupled WC 1.5–2 hours
Wall-hung WC with concealed cistern 3–4 hours (frame, cistern, pan)
Pedestal basin 1.5–2 hours
Countertop or semi-recessed basin 2–3 hours (plus vanity unit build if applicable)
Standard shower enclosure 2–3 hours
Frameless glass enclosure 4–6 hours (profiles, silicone, alignment)
Vinyl floor laying 1–2 hours average bathroom
Accessories (mirrors, towel rails, toilet roll holders) Allow 1–1.5 hours

Do not forget silicone sealing — bath, shower tray, basin and WC all need careful bead work. Allow at least one hour for sealing across a typical bathroom fit. Rushed silicone is one of the most common callbacks.

Waste, Contingency and the Final Number

Once you have all your line items priced, there are two additions before you arrive at the quote figure: waste/skip costs and contingency.

bathroom takeoff sheet example uk
A well-structured takeoff sheet captures every cost element before the quote is assembled — and protects your margin.

Waste and Skip Allowances

For a full bathroom renovation in a standard property, expect:

  • Half skip (3 cubic yards): £120–£200 depending on location and access
  • Full skip (6 cubic yards): £220–£400 for heavier debris loads
  • Man and van removal (if no skip access): £150–£250 per load
  • Asbestos disposal — quoted separately by licensed waste contractor

Contingency

Always include a contingency allowance. For a bathroom in an older property — pre-1980 build — I allow 10–15% on top of my priced items to cover sub-floor rot discovered once the floor is up, drainage runs that do not go where the plans suggest, or plasterwork that crumbles once the tiles are off. In a newer build, 5–7.5% is usually enough. State the contingency as a line item so the client knows it is there. A transparent contingency is a professional allowance — not padding.

For faster, more accurate bathroom quotes, try RenoCalc — upload the bathroom layout and get a full line-item breakdown in minutes.

Presenting the Quote Professionally

How you present a quote matters almost as much as what is in it. A quote on a torn scrap of paper with a single number at the bottom tells the client nothing — and gives them every reason to shop you on price alone. A structured, readable document tells the client you know what you are doing.

sample bathroom quote template uk
A professional bathroom quote template shows every cost element clearly — giving the client confidence and protecting your margin.

What a Bathroom Quote Should Include

  1. Client name, property address and date
  2. Brief description of the scope of works
  3. Itemised breakdown by trade: strip-out, plumbing first fix, electrical first fix, boarding/prep, tiling, sanitaryware second fix, flooring, accessories
  4. Materials costs where you are supplying (or note "client-supplied" where relevant)
  5. Waste and skip allowance
  6. Contingency (labelled clearly)
  7. Exclusions list — what is NOT included
  8. Assumptions — tile format, lead times, access hours
  9. Payment stage schedule
  10. Quote validity period — typically 30 days
  11. Your company details, insurance and any relevant certification

Keep the language plain. Write it for the client, not for yourself. If they can read it and understand exactly what they are getting and what they are not getting, you have done it right.

Ready to speed up your quoting process? RenoCalc generates detailed bathroom renovation breakdowns so you spend less time in spreadsheets and more time on site. You can also use our floor plan cost estimator to cross-check room areas and cost per square metre.
